What a GeoHome foundation has to do and the options Arctic Acres has engineered plans for.
Your geodesic dome foundation is one of the most important technical decisions in a GeoHome project. It determines how the structure is supported, anchored, levelled, protected from ground movement, and connected to utilities. The right foundation approach depends on your site conditions, climate, intended use, local requirements, and contractor or engineering recommendations. Arctic Acres has engineered plans for each foundation option outlined, available for project planning.
What Your Foundation Needs to Do
A properly designed foundation should:
Provide a level, stable base for the GeoHome
Anchor the structure securely to the ground
Minimize movement from frost cycles and shifting soil
Help manage drainage and support long-term performance
Account for any subterranean utility lines
Planning Considerations
Plan your foundation early, as it affects both construction and long-term performance:
Complete the foundation before delivery to allow for immediate assembly
Assess site conditions, including soil, drainage, and frost depth
Verify local building codes or permit requirements
Plan utility routing (water, power, airflow) before construction
Ensure the foundation is level and accurately aligned
Some foundation types may require excavation, forming, or contractor involvement depending on site conditions and complexity. Some foundation types may be required to meet local building codes or permit conditions.

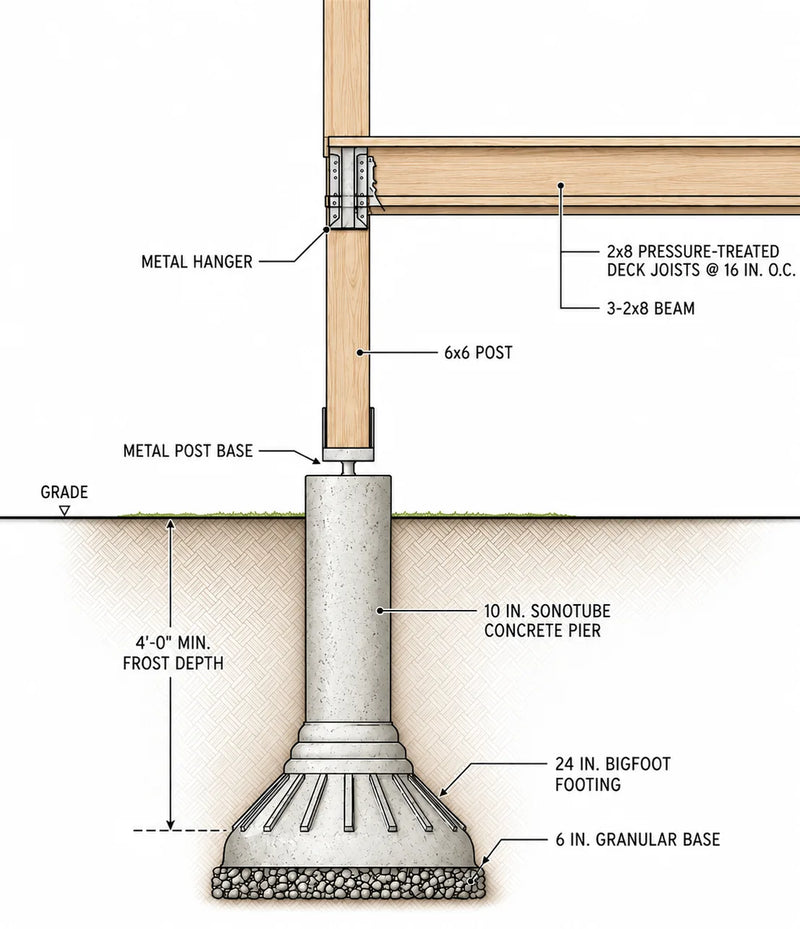

1. Concrete Piles
Concrete pile foundations use formed concrete footings or piers to support the structure at key load points. This approach can be suitable for permanent installations and sites where a contractor can complete excavation, forming, concrete placement, and anchoring according to the project drawings.

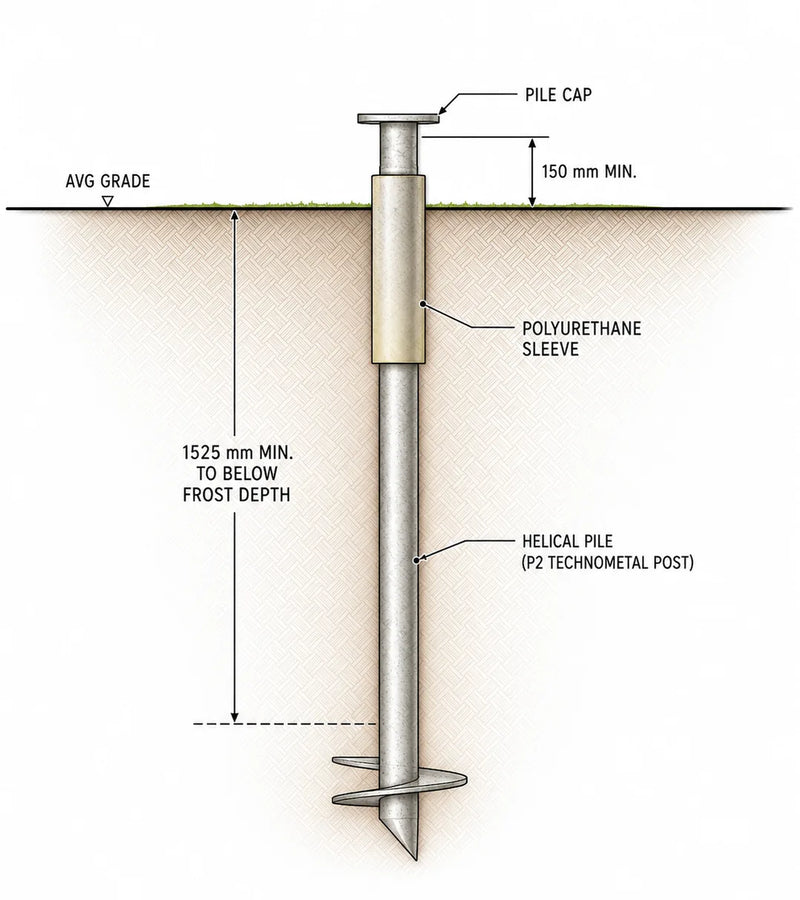

2. Helical Piles
Helical piles are installed into the ground using specialised equipment and can provide a faster, low-excavation foundation option. They may be useful where soil conditions, site access, or project timing make traditional concrete work less practical, but they must be installed according to manufacturer and engineering requirements.

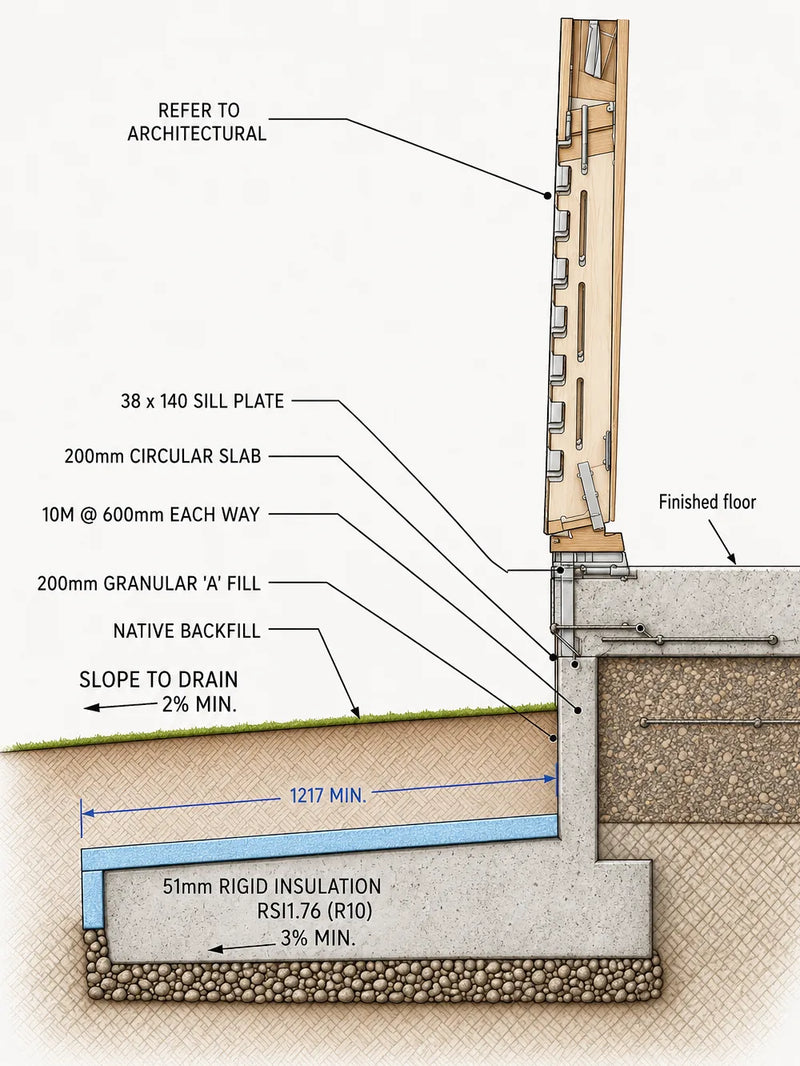

3. Insulated Slab

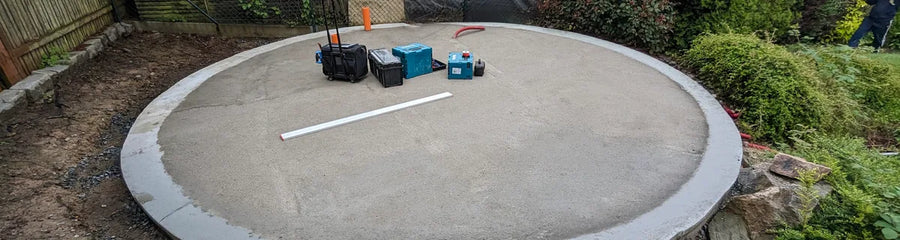

An insulated slab provides a continuous foundation and floor base with added thermal performance. This option may be well-suited for projects where year-round comfort, finished flooring, utility routing, and long-term permanence are priorities.
ICF and Other Site-Specific Options
Insulated Concrete Form foundations and other site-specific approaches may be considered depending on the property, climate, intended use, and local requirements.
These options may require additional design work, contractor coordination, or engineering review, particularly if they differ from the standard foundation drawings provided for the project.
Anchoring, Frost, and Drainage
A geodesic dome foundation must do more than support the structure. It should also account for anchoring, frost movement, soil conditions, drainage, and long-term stability.
Backfill, grading, and surrounding site work should direct water away from the foundation and help reduce movement caused by seasonal freeze-thaw cycles.
Utility and Service Planning
Utility routes should be considered before foundation work begins. Electrical, plumbing, wastewater, propane, data, and other services may pass through the foundation, floor system, or wall assembly depending on the final design.
Planning these routes early can help avoid unnecessary cutting, rework, or layout conflicts later.
